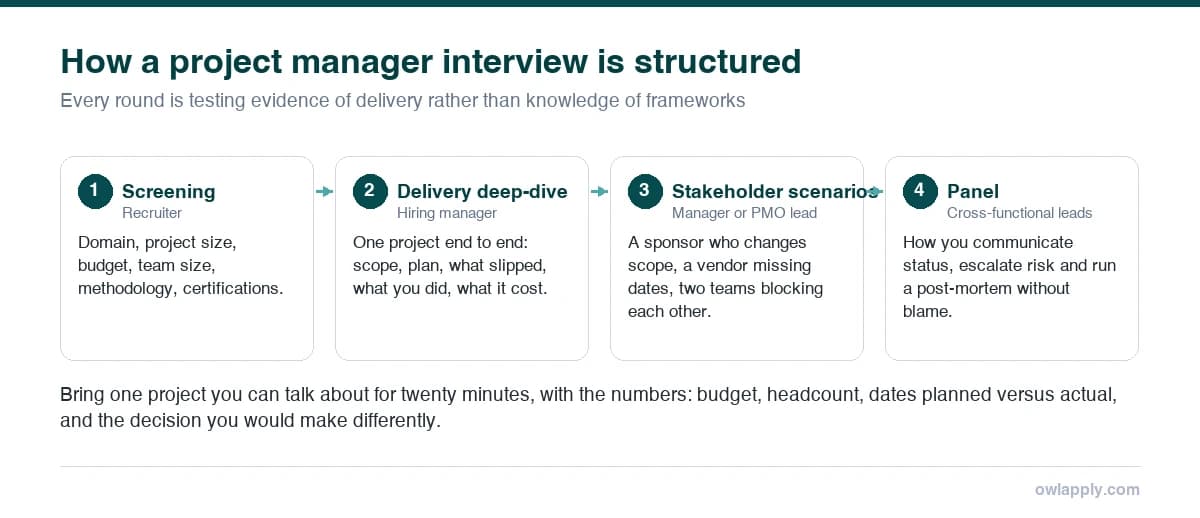

Project manager interview questions in 2026 test four things: whether you have actually delivered projects (behavioral questions about scope, budget and stakeholders), how you would handle a problem on their project (situational questions), whether you know the methods (Agile, Scrum, Waterfall, risk, budget control), and whether you fit the team. The strongest answers walk through one real project with numbers: budget, team size, dates planned versus actual.
Below are the questions with full sample answers you can copy and adapt: 10 behavioral STAR answers, 8 situational answers, technical questions with worked examples (critical path, earned value, risk register, Agile versus Waterfall, Scrum), variants for entry-level and IT project managers, a list for hiring managers who want questions to ask a project manager candidate, and the questions you should ask at the end.

What interviewers are assessing in a project manager
Hiring managers are looking for evidence that you can deliver through other people, not that you can recite a framework. The US Bureau of Labor Statistics lists the qualities project management specialists need as analytical, communication, critical-thinking, interpersonal, organizational, problem-solving and time-management skills. Each question type tests a different part of that list:
| Question type | Example | What a strong answer shows |
|---|---|---|
| Behavioral (past) | "Tell me about a project that went over budget." | A real project, your own actions, a measurable result, what you would change |
| Situational (hypothetical) | "Your sponsor wants a new feature two weeks before launch." | Impact analysis, options, a decision path that goes through change control |
| Technical (methods) | "How do you calculate the critical path?" "What is CPI?" | You can do the arithmetic and explain what you would do with the answer |
| Fit and motivation | "Why project management?" "Why this company?" | Interest in the domain and a working style that matches theirs |
| Questions for them | "What does success look like at six months?" | That you are judging the project's health as well |
The 10 most common project manager interview questions
The ten questions you are most likely to be asked are: tell me about yourself, walk me through a project you managed, how do you handle scope creep, tell me about a project that failed, how do you prioritize, how do you manage stakeholders, how do you handle an underperforming team member, which methodologies do you use and when, how do you manage risk, and how do you keep a project on budget. Each is answered below.
| # | Question | Answer on this page |
|---|---|---|
| 1 | Tell me about yourself. | Sample answer |
| 2 | Walk me through a project you managed from start to finish. | Sample answer |
| 3 | How do you handle scope creep? | Sample answer |
| 4 | Tell me about a project that failed or went wrong. | Sample answer |
| 5 | How do you prioritize when everything is urgent? | Sample answer |
| 6 | How do you manage difficult stakeholders? | Sample answer |
| 7 | How do you handle an underperforming team member? | Sample answer |
| 8 | Agile or Waterfall: how do you choose? | Sample answer |
| 9 | How do you identify and manage risk? | Sample answer |
| 10 | How do you keep a project on budget? | Sample answer |
"Tell me about yourself."
Give a 60-second summary built around the project constraints the job cares about: the size and type of projects you run, your methods, one result with numbers, and why this role is next. There are more structures in tell me about yourself sample answers.
"Walk me through a project you managed from start to finish."
This is the deep-dive question, and the hiring manager will interrupt with follow-ups, so pick a project you know in detail. Cover the goal, scope, team, method, budget and dates, the biggest problem and what you did, and the result versus plan. Keep the first pass to about two minutes and let them dig.
Behavioral project manager interview questions with STAR answers
Behavioral questions ask what you did, so answer with STAR (Situation, Task, Action, Result). Spend most of the time on the action, use "I" for your decisions, and finish with a number. For the general method, see behavioral interview questions and the STAR method.
"How do you handle scope creep? Give an example."
Why it works: it shows a formal change process without sounding bureaucratic, quantifies the impact, and lets the sponsor decide. PMI's own sample PMP question on this situation says the same: evaluate the impact and follow the change control process.
"Tell me about a project that failed or went badly."
Why it works: it is a real failure, you own your part, and the lesson is a concrete change in how you work. Avoid a failure that was entirely someone else's fault.
"Tell me about a difficult stakeholder."
"How do you handle an underperforming team member?"
"Tell me about a conflict between team members."
"How do you prioritize when everything is urgent?"
"Tell me about a time you missed a deadline."
"Tell me about a time you led without authority."
"How do you manage a remote or distributed team?"
Situational and scenario-based project manager questions
Situational questions describe a problem and ask what you would do. Interviewers want a sequence: understand the facts, assess the impact on scope, time, cost and quality, generate options, involve the right decision maker, then communicate and document. Give a decision, not a list of possibilities.
"Your project is three weeks behind schedule. What do you do?"
"You discover the project will be 15% over budget."
"Your sponsor wants a major change two weeks before launch."
"Your team says the deadline is impossible."
"Your lead developer resigns mid-project."
"A vendor tells you a delivery will be two weeks late."
"You inherit a failing project. What do you do in your first two weeks?"
"A stakeholder asks you to report the project as green when it is not."
Why it works: it refuses without drama and offers a better route. Honesty is one of the four values in PMI's Code of Ethics and Professional Conduct, alongside responsibility, respect and fairness.
Technical project management interview questions
Technical questions check that you can use the tools, not just name them. Answer with a short definition, then an example of when you used it.
"What is the difference between Agile and Waterfall, and how do you choose?"
Waterfall (predictive) plans the whole project up front and moves through phases in sequence; Agile delivers in short iterations and expects requirements to change. Choose Waterfall when requirements are stable and changes are expensive (construction, regulated hardware), Agile when the product will be shaped by user feedback (software), and hybrid when you need both.
| Waterfall (predictive) | Agile | Hybrid | |
|---|---|---|---|
| Planning | Detailed plan and baseline up front | High-level roadmap, detailed planning each iteration | Fixed milestones, iterative delivery between them |
| Change | Through formal change control | Expected; the backlog is reprioritized | Change control at milestone level, backlog inside |
| Delivery | One delivery at the end of each phase | Working increment every iteration | Increments plus planned releases |
| Best when | Requirements are fixed, rework is expensive | Requirements will change with feedback | Fixed date or budget with an uncertain solution |
| Typical example | Office fit-out, ERP finance close process | Mobile app, internal tool | Client implementation with a contract date |
"Explain Scrum. What does a Scrum Master do compared with a project manager?"
According to the 2020 Scrum Guide, a Scrum Team has three accountabilities (one Scrum Master, one Product Owner and Developers), five events (the Sprint, Sprint Planning, the Daily Scrum, the Sprint Review and the Sprint Retrospective) and three artifacts, each with a commitment: the Product Backlog (Product Goal), the Sprint Backlog (Sprint Goal) and the Increment (Definition of Done). Sprints are one month or less, and the Daily Scrum is 15 minutes. Scrum has no project manager role: the Scrum Master coaches the team and removes impediments, the Product Owner owns the backlog. In many companies a project manager works alongside, managing budget, contracts, dependencies on other teams and reporting to stakeholders.
"What is the critical path, and how do you calculate it?"
The critical path is the longest sequence of dependent tasks through the project; it sets the shortest possible duration, and any delay on it delays the finish. Calculate it by adding up the durations along each path through the dependency network and taking the longest.
| Task | Duration | Depends on |
|---|---|---|
| A. Requirements | 3 days | None |
| B. Build back end | 5 days | A |
| C. Design screens | 2 days | A |
| D. Integrate | 4 days | B |
| E. Build front end | 3 days | C |
| F. Test and release | 2 days | D and E |
The interview follow-up is usually "so what?": you would watch B and D most closely, a one-day slip on either moves the release, and you could delay the front-end work by up to four days without affecting the date.
"What is earned value? How would you calculate CPI and SPI?"
Earned value management compares the value of work actually done (EV) with the planned value (PV) and the actual cost (AC). The cost performance index CPI = EV / AC and the schedule performance index SPI = EV / PV; below 1.0 means over budget or behind schedule. Here is a worked example you can talk through:
| Measure | Formula | Example | Meaning |
|---|---|---|---|
| Budget at completion (BAC) | Total approved budget | $200,000 | The plan |
| Planned value (PV) | Budgeted cost of work scheduled to date | $100,000 (50% planned by month 3) | Where we should be |
| Earned value (EV) | % actually complete × BAC | $80,000 (40% complete) | Value delivered |
| Actual cost (AC) | What was spent | $95,000 | Money gone |
| Cost variance | EV − AC | −$15,000 | Over budget |
| Schedule variance | EV − PV | −$20,000 | Behind schedule |
| CPI | EV ÷ AC | 0.84 | 84 cents of value per dollar spent |
| SPI | EV ÷ PV | 0.80 | Progressing at 80% of the planned rate |
| Estimate at completion | BAC ÷ CPI | $237,500 | Forecast final cost if efficiency stays the same |
A good answer goes one step further: "With a CPI of 0.84, I'd tell the sponsor the forecast is about $237,500 unless something changes, and I'd find out whether the overrun comes from rates, rework or scope."
"How do you identify and manage risk?"
Identify risks with the team and stakeholders at the start and at every phase, log them in a risk register with probability, impact, an owner and a response, and review the top risks every week. Responses to threats are usually avoid, transfer, mitigate or accept; for opportunities, exploit, share, enhance or accept.
"How do you build and control a project budget?"
"How do you manage stakeholders?"
Identify everyone affected, map them by power and interest, and plan how you will engage each group: manage closely the people with high power and high interest, keep satisfied those with high power and low interest, keep informed those with high interest and low power, and monitor the rest. Then agree how often and in what form each group hears from you, and check that it is working.
Other technical questions to prepare
| Question | Short answer |
|---|---|
| What is a work breakdown structure (WBS)? | A hierarchical breakdown of the total scope into deliverables and work packages small enough to estimate and assign. |
| What is a RACI matrix? | A table showing who is Responsible, Accountable, Consulted and Informed for each deliverable or decision. Only one person is Accountable. |
| What is the triple constraint? | Scope, time and cost: changing one affects the others, and quality depends on all three. |
| Fast-tracking vs crashing? | Fast-tracking runs sequential tasks in parallel (more risk); crashing adds resources to critical tasks (more cost). |
| What is a project charter? | The document that authorizes the project, names the sponsor and PM, and sets objectives, high-level scope, budget and success criteria. |
| Velocity and burndown? | Velocity is the work a team completes per sprint, used for forecasting; a burndown chart shows the work remaining against time. |
| What is Kanban? | A flow method: visualize work on a board, limit work in progress, and manage the flow rather than fixed iterations. |
| Which tools do you use? | Name the ones you know (for example Jira, MS Project, Smartsheet, Asana) and what you used them for, then say you adapt to the team's tool. |
"Do you have a PMP? Is it required?"
Answer honestly, and if you do not have it, say what you are doing about it. According to PMI, the PMP exam has 180 questions in 240 minutes, split across People (33%), Process (41%) and Business Environment (26%). To sit it you need 35 hours of project management training (or an active CAPM) plus experience leading projects: 3 years with a bachelor's degree, 4 with an associate's degree, 5 with a high school diploma, or 2 with a degree from a PMI-accredited program. Holders earn 60 professional development units every three years to keep it. Many PM postings list PMP as preferred rather than required; the interview will still test the experience behind it.
Entry-level project manager interview questions
For entry-level, junior PM and project coordinator roles, interviewers do not expect a list of large projects. They want organization, follow-through and communication, shown through school projects, events, part-time work or projects you led informally in another job. Typical questions:
- Why do you want to be a project manager?
- Tell me about a project you organized, even if it wasn't your job title.
- How do you keep track of tasks and deadlines?
- What would you do if a team member didn't deliver their part on time?
- Which project management tools have you used?
- What do you know about Agile or Scrum?
- Are you working toward a certification such as the CAPM?
For the résumé side, the entry-level project management résumé examples and project coordinator résumé examples show how to present informal projects as experience.
IT and technical project manager interview questions
IT, software and technical project manager interviews add questions about the software delivery life cycle and about working with engineers. You do not need to code, but you need to understand what engineers are telling you.
- How do you work with engineers on estimates you can't check yourself?
- How do you handle technical debt competing with new features?
- Walk me through a release you managed, including rollback.
- How do you manage dependencies on other teams or platforms?
- A production incident hits during your release week. What do you do?
- How do you translate technical risk for a non-technical sponsor?
- What does your ideal Definition of Done include?
See the technical project manager résumé examples for how to show delivery metrics in an IT context.
Construction, senior and other project manager interviews
| Role | Questions you will also get | What they listen for |
|---|---|---|
| Construction project manager | How do you manage subcontractors? How do you handle a change order? Tell me about a safety incident on site. | Contracts and change orders, safety culture, schedule recovery, cost control |
| Engineering project manager | How do you manage design reviews and technical risk? How do you handle a failed test? | Stage gates, requirements traceability, working with specialists |
| Senior project / program manager | How do you manage a portfolio of projects with shared resources? How do you report to executives? | Benefits realization, governance, influencing at executive level |
| AI or data project manager | How do you plan a project when you don't know if the model will work? | Experiments with go/no-go points, data quality risk, iterative scope |
| Agile or Scrum roles | How do you handle a Product Owner who changes priorities mid-sprint? | The Scrum Guide's rules, coaching rather than commanding |
What are the top 5 skills of a project manager?
The top five skills interviewers look for in a project manager are communication, planning and organization, risk and problem solving, stakeholder management (influencing without authority), and leadership of a team you often do not manage directly. They match the qualities the BLS lists for the occupation; show each one with an example rather than naming it.
Is 90% of a project manager's job communication?
It is a well-known rule of thumb rather than a measured figure: no study sets the share at exactly 90%. The point behind it is sound, though. Most of the work is status, negotiation, escalation and keeping people aligned, so interviewers listen closely to how clearly you explain your answers.
What are the 5 C's or 7 C's of project management?
There is no official list: PMI's standards do not define "5 C's" or "7 C's", and trainers use different versions (communication, collaboration, clarity, commitment and control are common picks). If you are asked, say that, then name the two or three that matter most in your own work and give an example. The interviewer is testing your thinking, not your memory of a slogan.
Interview questions to ask a project manager candidate
If you are hiring a project manager, ask for evidence of delivery and listen for specifics. These questions separate experienced PMs from people who have studied the vocabulary:
| Question | A strong answer includes | Warning sign |
|---|---|---|
| Walk me through your last project's budget versus actual. | Numbers, the reason for the variance, what they did about it | "We were basically on budget" with no figures |
| Tell me about a project that failed. | Their own part in it and a changed habit | Blaming the client or the team |
| How did you find out your last project was in trouble? | A specific signal and how early | Finding out at the deadline |
| Show me how you report status. | A clear format and honest ambers and reds | Everything was always green |
| How do you handle a change request from the sponsor? | Impact analysis and a decision by the sponsor | Saying yes to keep them happy |
| What would you do in your first 30 days here? | Listening, reviewing the plan and risks, re-baselining if needed | Changing tools and processes immediately |
Questions to ask in a project manager interview
Ask questions that show you are already thinking about how to deliver their projects. For a longer list, see questions to ask the interviewer.
- How is success measured for this role in the first six months?
- What does the current project portfolio look like, and which project is most at risk?
- What methodology do teams use, and how much can a PM adapt it?
- How much authority will I have over budget and scope decisions?
- Who are the key stakeholders, and how do they prefer to be updated?
- What tools does the team use for planning and reporting?
- What happened to the last person in this role?
- What is the biggest challenge the team is facing right now?
What the 2026 job market looks like
The Bureau of Labor Statistics counted 1,094,300 project management specialist jobs in the US in 2025, with a median annual pay of $102,320 in May 2025. It projects 7% employment growth from 2025 to 2035 and about 76,500 openings a year on average. The typical entry-level education is a bachelor's degree.
Project management specialists in the US (BLS, page modified August 27, 2026)
- $102,320
- median annual pay, May 2025
- 1,094,300
- jobs in 2025
- 7%
- projected growth, 2025 to 2035
- 76,500
- average openings per year
Your résumé lists the skills. The interview has to prove them.
Mistakes that weaken a project manager interview
Do this
- Use one or two real projects with budget, team size and dates
- Say "I" for your own decisions
- Show a decision path: impact, options, sponsor decision
- Admit a failure and the habit it changed
- Explain methods with an example of when you used them
- Ask about authority, stakeholders and the riskiest project
Avoid this
- Don't describe every project you have ever run
- Don't hide behind "we" so the interviewer cannot see your part
- Don't say yes to every scope change to sound flexible
- Don't claim a project that was always green
- Don't recite definitions with no example
- Don't criticize a former sponsor, client or team
Practice your answers out loud
Project answers tend to run long when spoken: the walk-through becomes five minutes, and the result gets lost. Say your main stories out loud with a timer, about two minutes each, and check that every one ends on a number.
The OwlApply AI mock interview lets you rehearse this as a spoken interview. Choose the interview type (HR, behavioral, technical or hiring manager) and one of 42 languages, and add your résumé and the job posting so the questions fit the role. The interviewer asks follow-ups the way a real one would, such as asking for an example when an answer stays vague, and does not coach you during the session. Afterwards you get a report built from the full transcript, with each answer scored and a stronger suggested version. If you have never done an interview on OwlApply, your first three-minute session costs nothing. Ten-minute sessions are part of the Pro plan: you can try Pro for 7 days for $2.95, which includes two sessions, then $17.49 a month unless you cancel.
Rehearse your project story before the panel
Run a spoken mock interview for the PM role you are applying to, then read your scored report with a stronger version of each answer. Your first three-minute session is free.
Practice my interview
